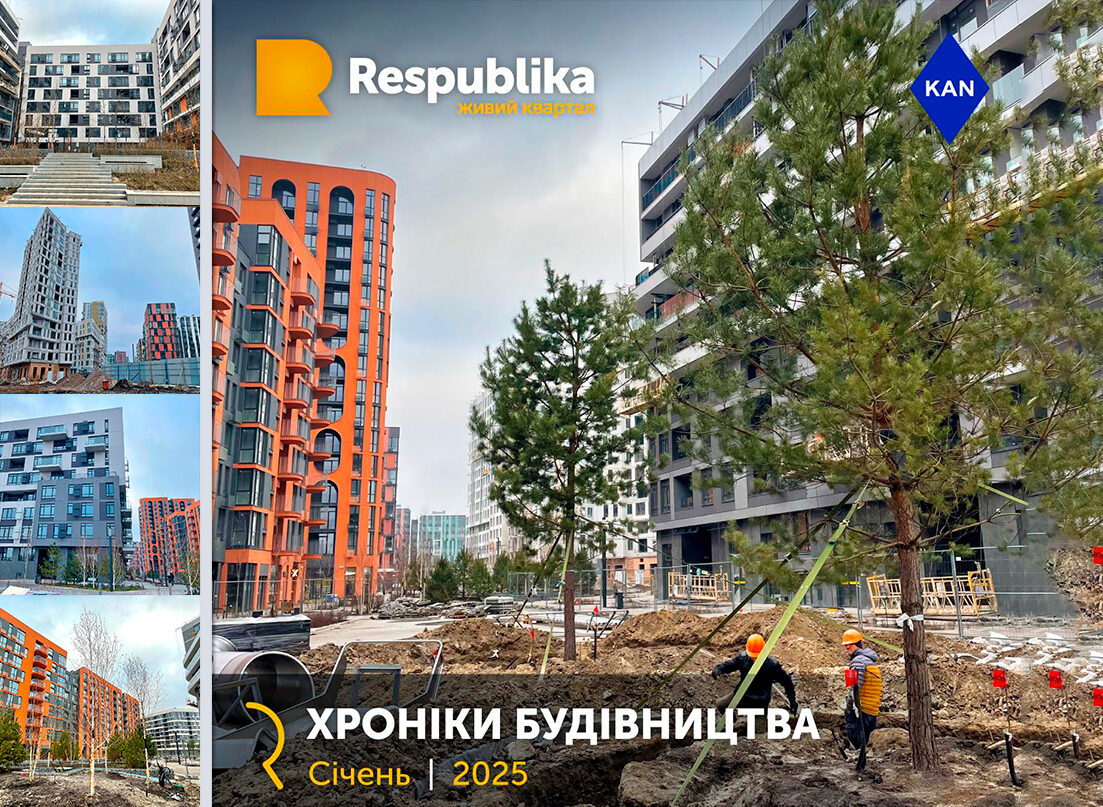

We have exciting news from the construction site of the Respublika residential complex: houses 228 and 304 are almost ready to welcome their residents! The walls have been erected, communications have been established, and the facades are blooming in their final beauty. Let us tell you about the latest achievements.
House 228
- monolithic works are 100% completed
- masonry works are 99% complete
- installation of translucent structures is 100% complete
- electrical work - 86% completed
- plumbing works - 94%
- installation of ventilation - 96%
- painting works - 22802,22803 - 87%
- tiling works - 228,02,22803 - 96%
- installation of apartment doors - 22803 - 99%, 22802-99%, 22801 - 15%
- screed installation - 22803 - 99.5%, 22802- 99.5%, 22801-99.5%
- roofing works -100%
- plastering works - 22803-99%, 22802-99%, 22801 - 50%
- facade works - 45%.
House 304
- monolithic works are completed by 100%
- masonry works by 99.8%
- screed installation is 100% complete (left in the basement)
- plastering works are 100% complete
- painting and tiling works - 98.9%
- installation of apartment doors 100%
- electrical work is 100% complete
- plumbing works are 98% complete
- roofing works are 100% completed (parking lot is left)
- landscaping - 97% completed
- installation of translucent structures is 100% complete
- facade works - completed by 95%
- installation of a ventilated facade - 90%
- installation of ventilation - 99.7%
- installation of external networks - 100%
